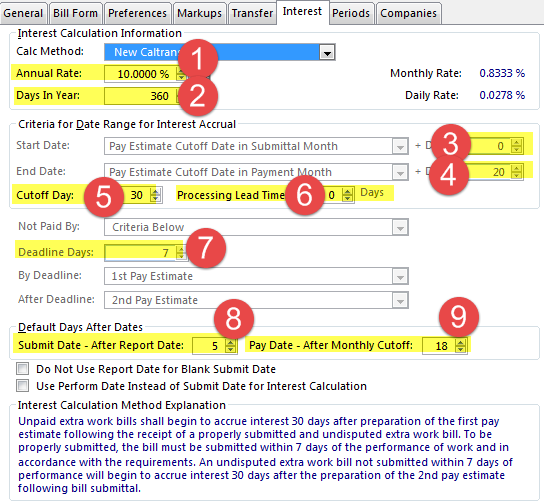

Annual Rate [JJM:InterestRate]
-
Days In Year[JJM:DaysInYear]
-
End Days After [JJM:EndDaysAfter]
-
Cutoff Day [JJM:CutoffDay]
-
Cutoff Days [JJM:StartDaysAfter]
-
Processing Lead Time [JJM:LeadTime]
-
Deadline Days [JJM:EarlyDueDay]
-
Submit Date - After Report Date [JJM:GracePeriod]
-
Pay Date - After Monthly Cutoff [JJM:DaysToPayment]
-

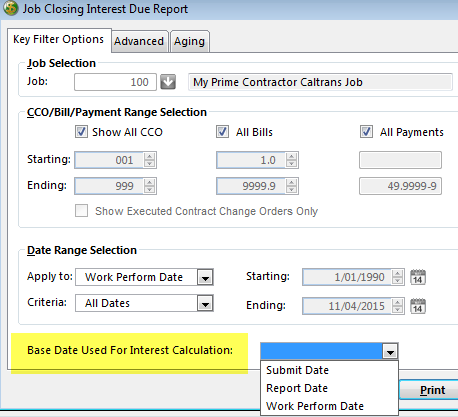

Base Date Used For Interest Calculation [gReportCriteria.BaseDate]
-
Cutoff Date [gReportCriteria.CutoffDate]
-
Submitted within 7 days of work perform date - interest starts accruing 30 days after the pay estimate date 20th of the month.
-
Looks like if submitted 8 days after the work perform date - interest starts accruing 30 days after the 2nd pay estimate 20th of the following month
-
Start Date = Pay Estimate Cutoff Date in Submittal Month
-
End Date = Pay Estimate Cutoff Date in Payment Month - 20th
-
Cutoff Day = 30 (need to see how this is being used)
