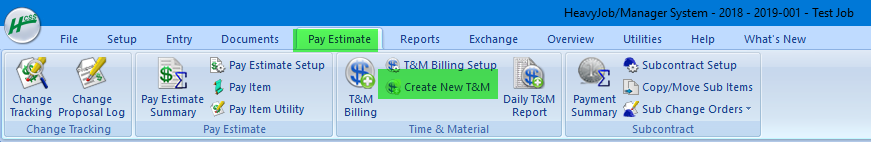

From the Pay Estimate tab, select Create New T&M in the Time & Material group.

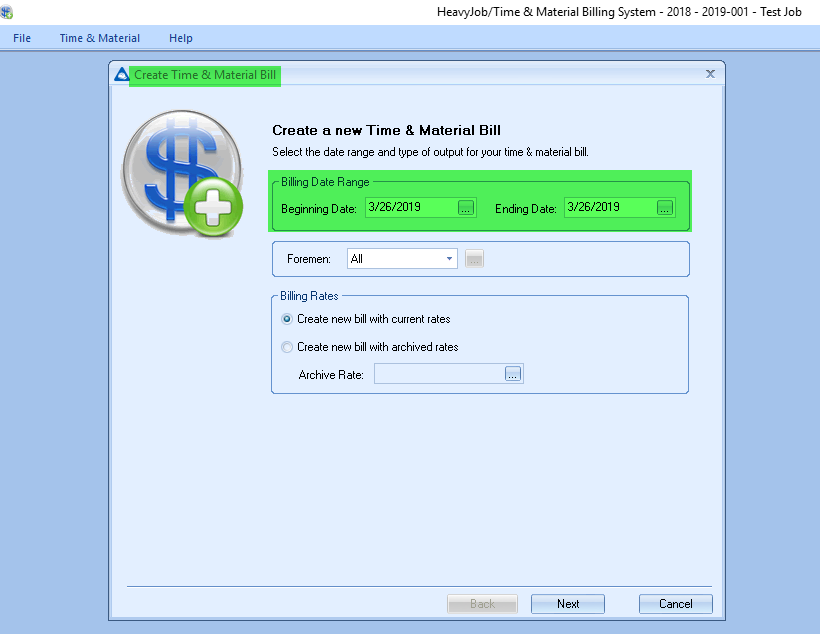

Then enter or select your Beginning and Ending Dates. Probably leave Foreman as All unless a specific group of timecards for a given foreman is the billing target. Ignore the Billing Rates since the rates will be looked up from EWBills.
After clicking the Next button, you will see the following:

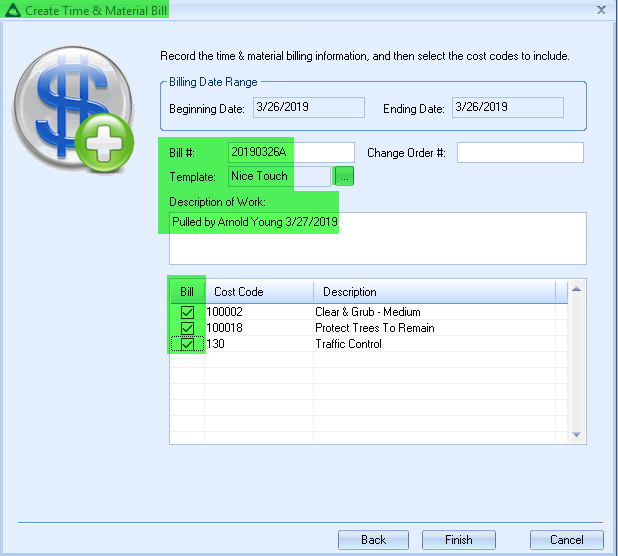

Bill # - which really is a Bill Batch unique number - so you cannot enter in previously used numbers. Instead of entering a series of integer numbers for this Bill# - consider using a date format of number like YYYYMMDD (year, month, day values) for the Starting Date as an example. If more than one batch per day for a given job by one or many people maybe add a digit after the day. You can be creative but we suggest you be consistent with a solid scheme otherwise you will get a warning if you happen to hit a previously used Bill #.

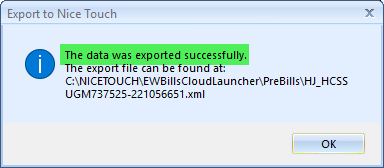

A confirmation window appears to show a successful export. The XML export file should have a name format of HJ_Job Number_YYYYMMDD_HHMMSS.xml.

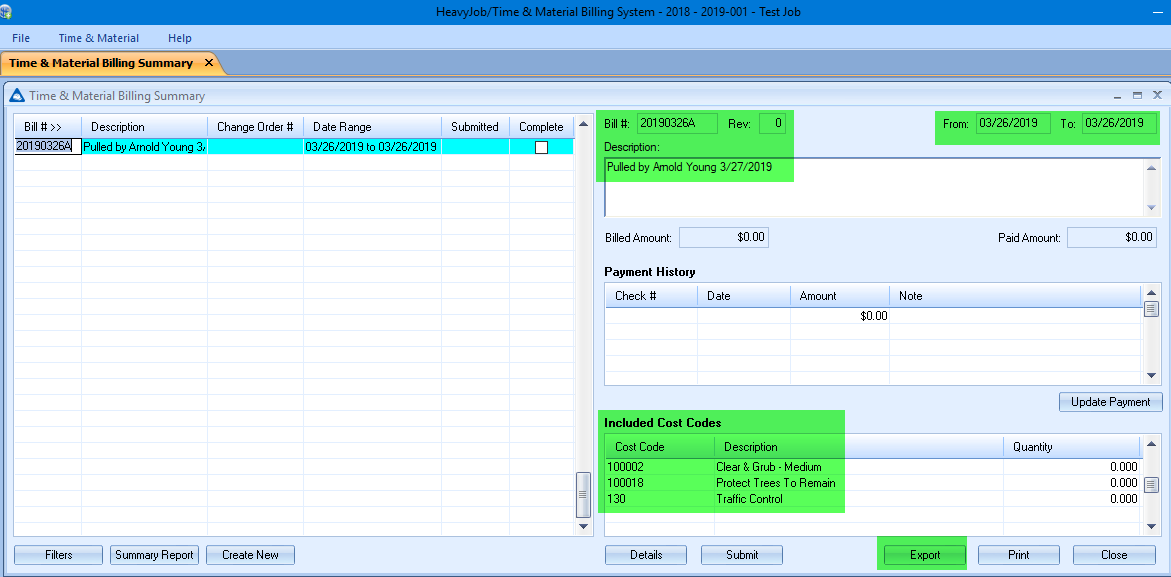

The file is now available for walking thru the PBM - Pre-Bill Module steps.
If the Bill Number that was manually entered already exists this is what you will see - hence we suggest the bill number convention of YYYYMMDDA - Year, Month, Date, Alpha Sequence Letter.
